Dams, tunnels,
rivers and rock
CP Systems builds, repairs, dredges and quarries in the Himalaya, Rajasthan and Bhutan, often inside a shutdown or a lean season.
- Established, run from New Delhi
- 1999
- Sites and units in India and Bhutan
- 22
- Granite reserves in Bhutan and Kekri
- 9 million MT
- Award for industrial contribution
- Udyog Ratan
Hard ground since 1999
CPS works where timing is tight and access is worse: under running rivers, inside tunnels, at 3,000 metres and in the quarry.
Clients are government departments, public sector undertakings such as THDC India, turnkey operators and builders. The work spans civil, anti-corrosive, mechanical and electrical execution, and a growing practice in civil and structural design.
How CPS works-

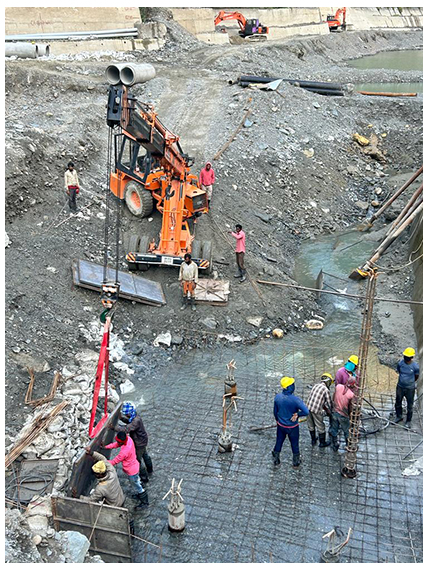

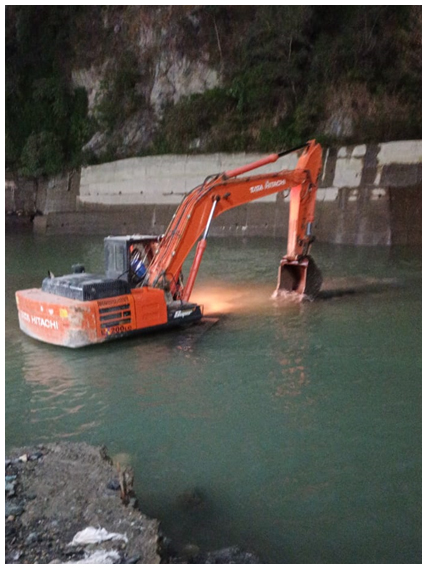

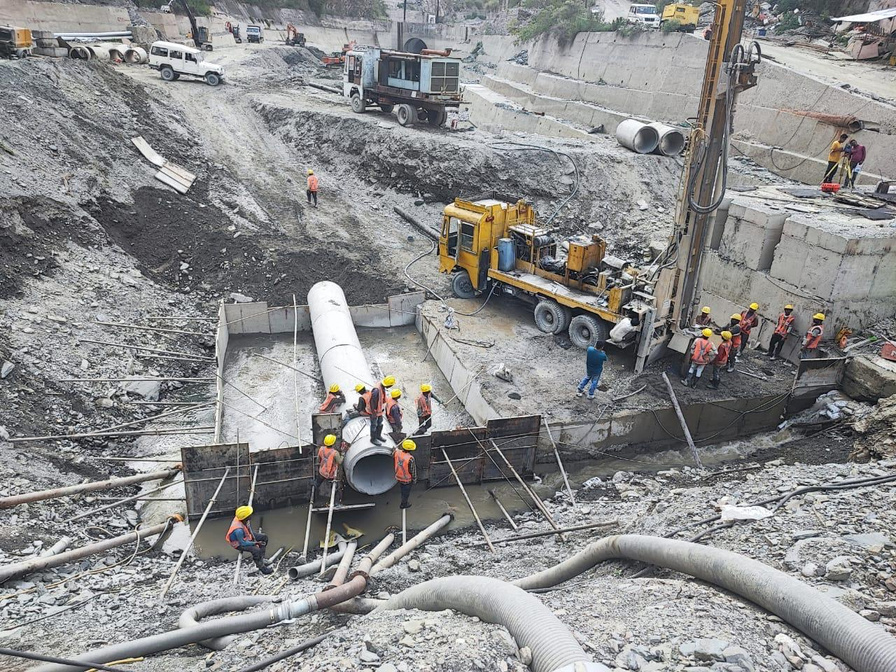

Hydropower & river dredging
Dredging, tunnel and spillway repair, gate grooves, grouting and epoxy, usually inside a shutdown.
-

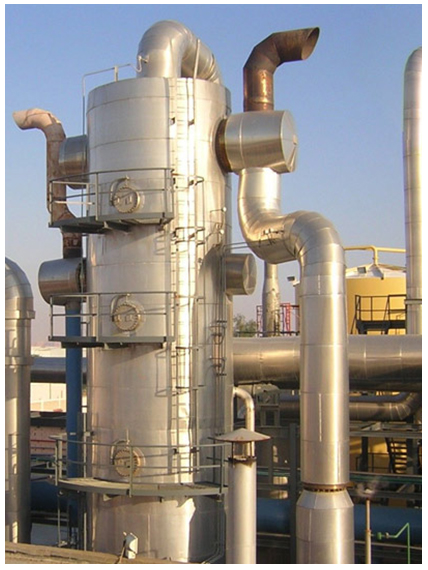

Civil & mechanical works
Riverfronts, pilgrim buildings, treatment plants, pipeline coating and fire protection.
-

Mining & exploration
Granite quarried in Bhutan and Rajasthan, then cut and finished in our own units.
Flagship projects
Four jobs that show the range: a dam in a shutdown, a shrine town on a glacial river, a tunnel under flow, a mine across the border.

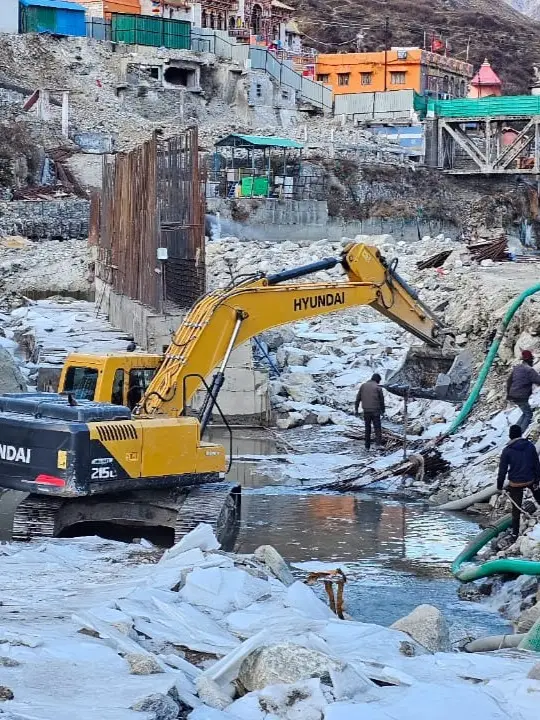

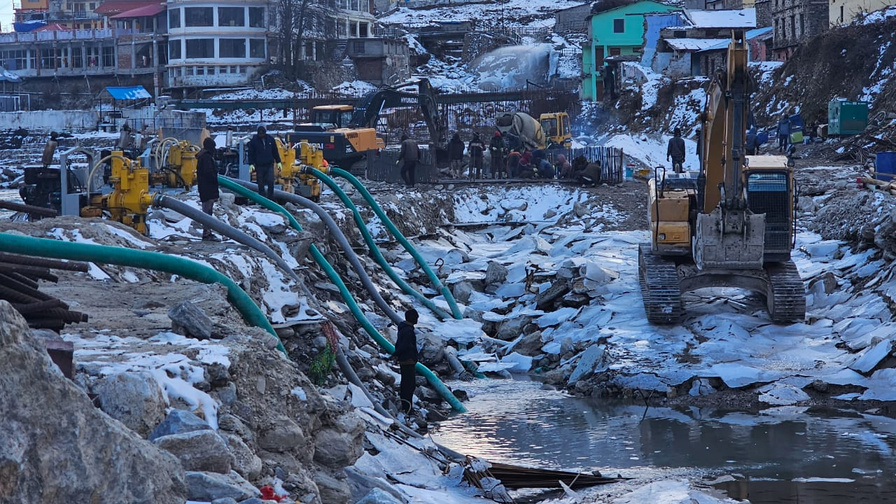

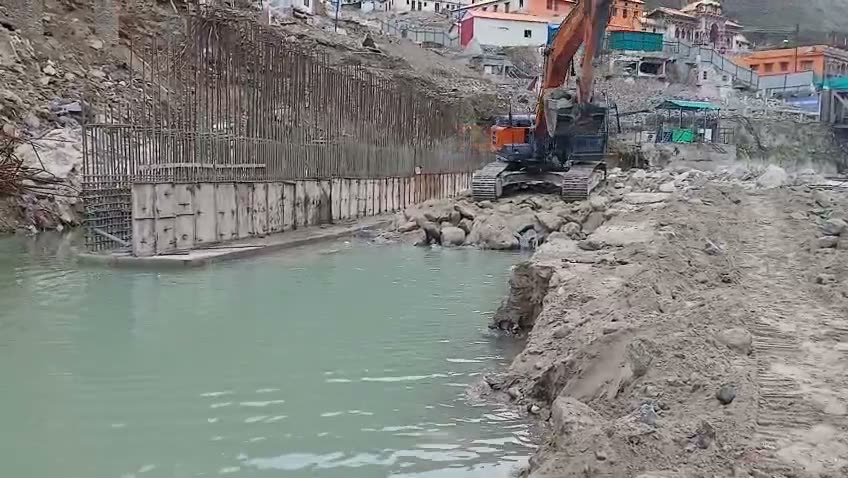

Badrinath Dham

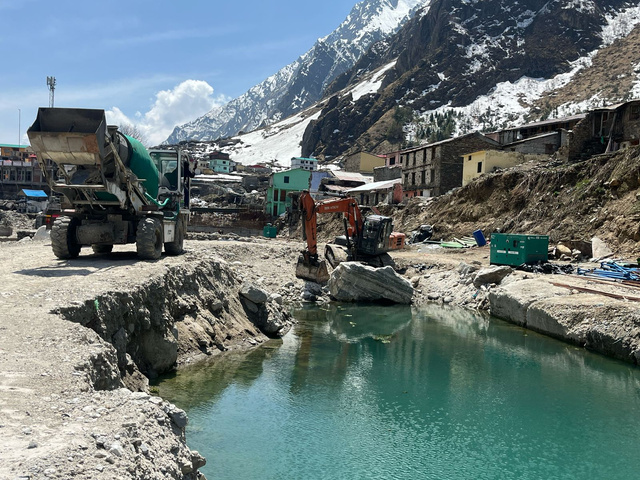

Riverfronts A and F1, a footbridge, a civic centre
Foundations 5–7 m below the riverbed
Work happens in windows
Shutdowns, lean seasons and handover dates decide when a crew can stand in the river. Drag through 2023 to 2025 to see where CPS was working.
Feb – Jul 2023

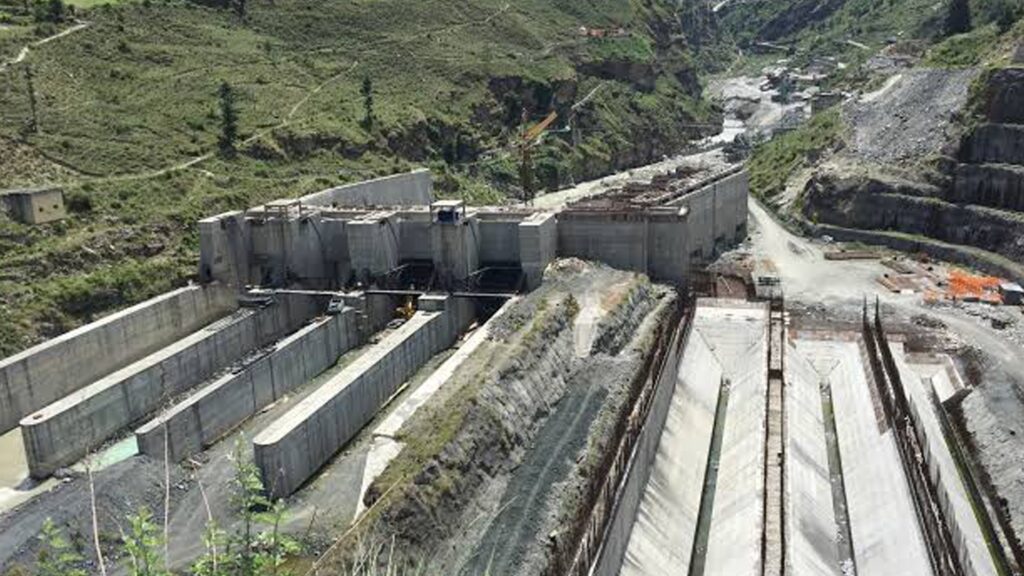

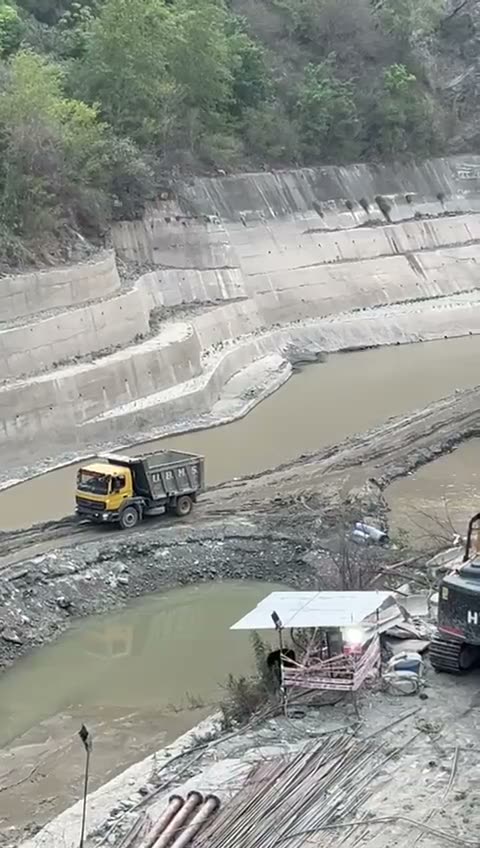

Tehri Dam: River dredging and baffle wall, phase 1

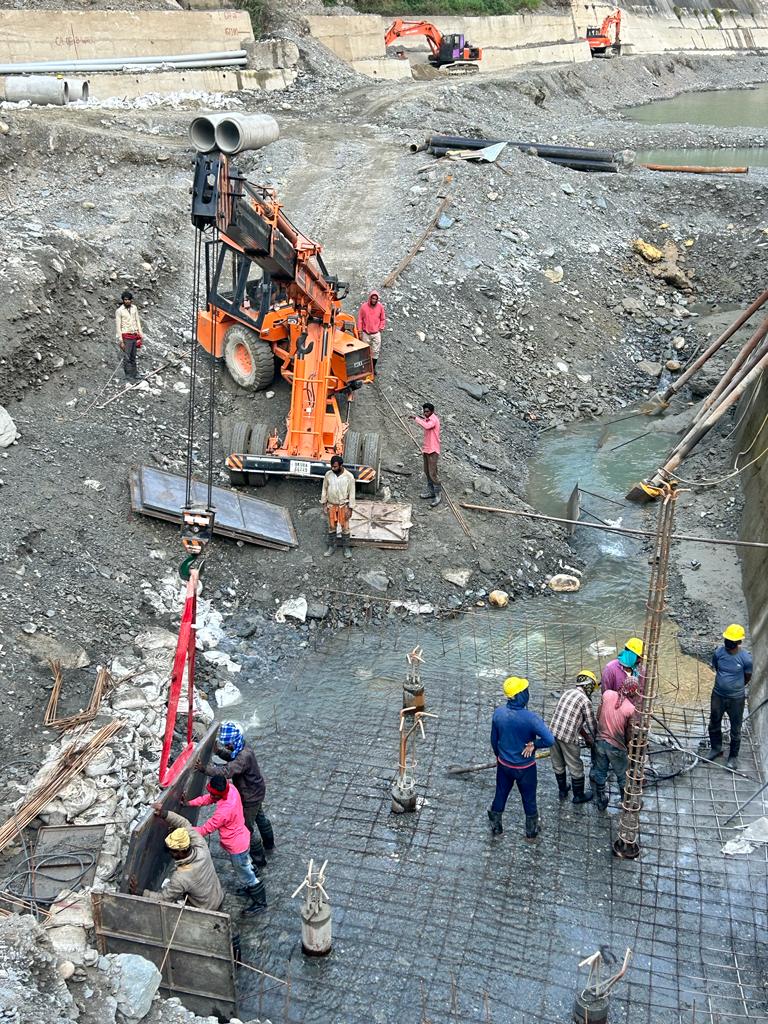

~1 lakh cum dredged and hauled 14–15 km, 47 m baffle wall across the Bhagirathi
Read the phaseJan – Mar 2024

Hailang Dam: Right side gate groove, phase 1
Lean season only: the diversion tunnel still carried 50–60 cumec
Read the phaseJun – Jul 2024

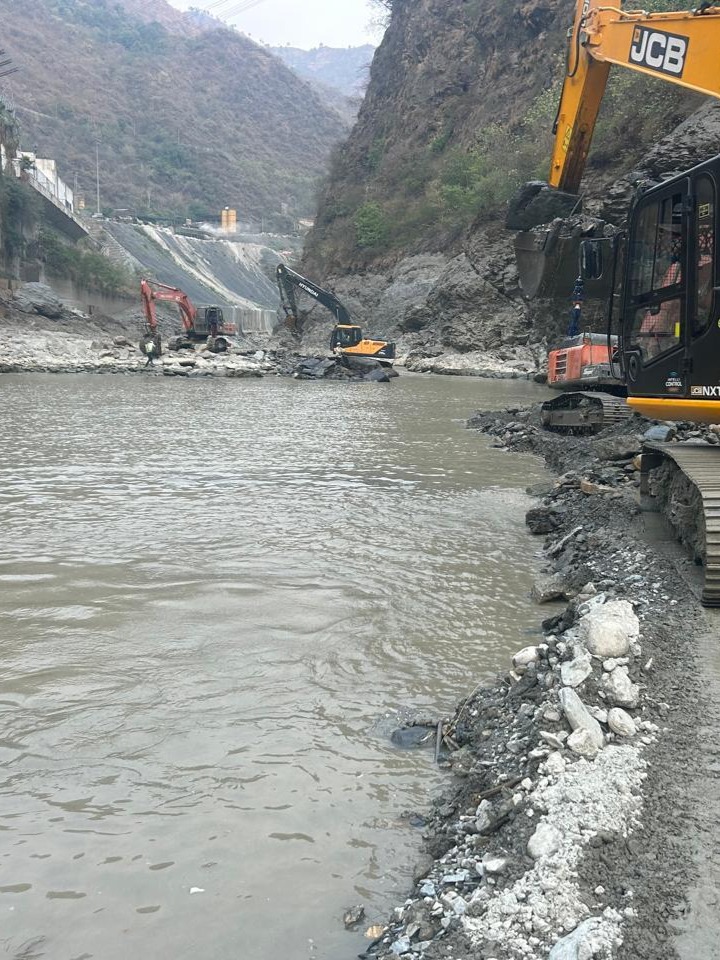

Tehri Dam: Dredging and ramps, phase 2
1,50,000 cum dredged and 14,400 cum concreted inside a 35-day shutdown
Read the phaseDec 2024 – Mar 2025

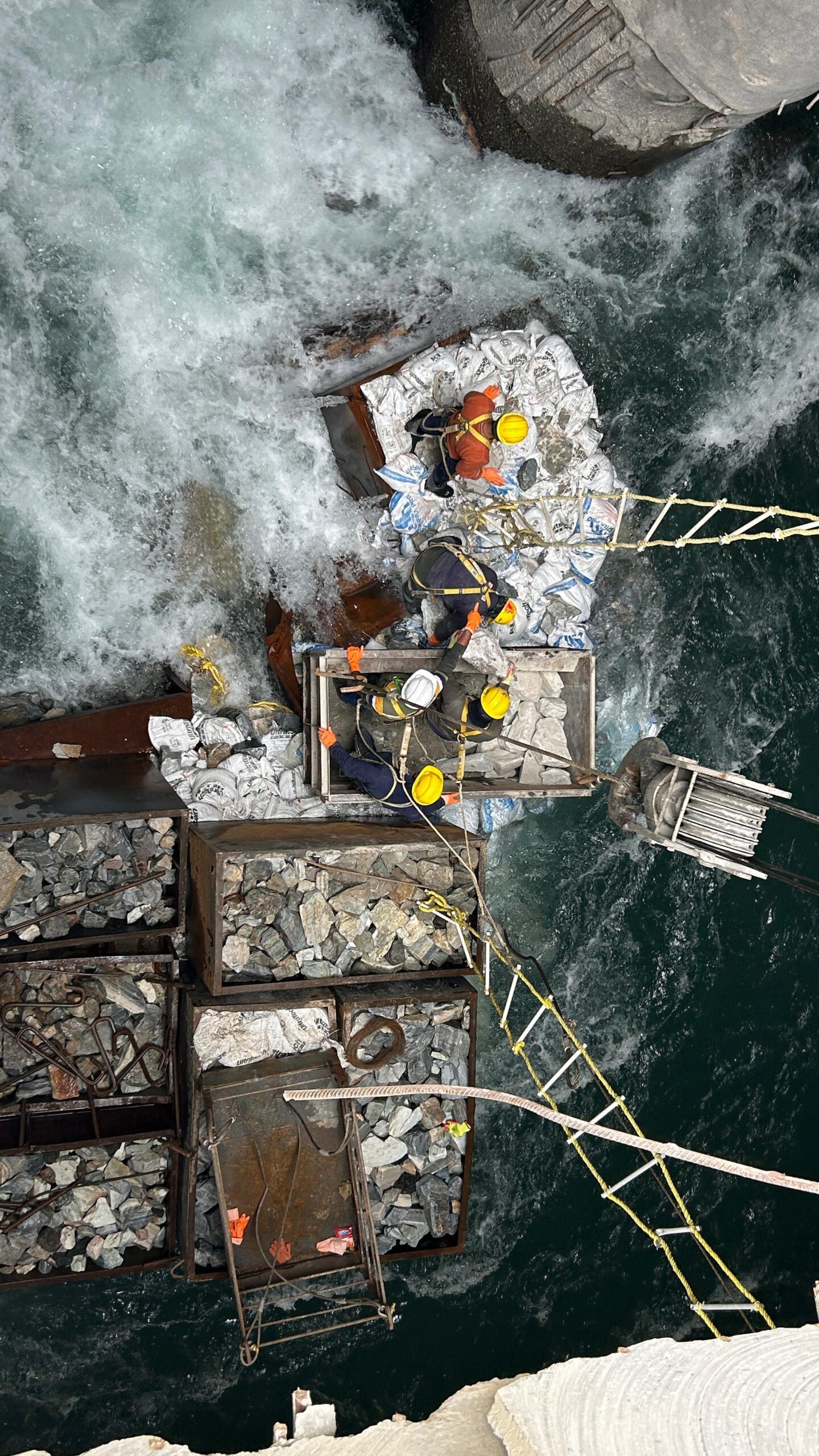

Hailang Dam: Left side gate groove, phase 2
Slab cut by wire saw, new steel anchored, micro concrete poured under water
Read the phase
31 May – 14 Jun 2025

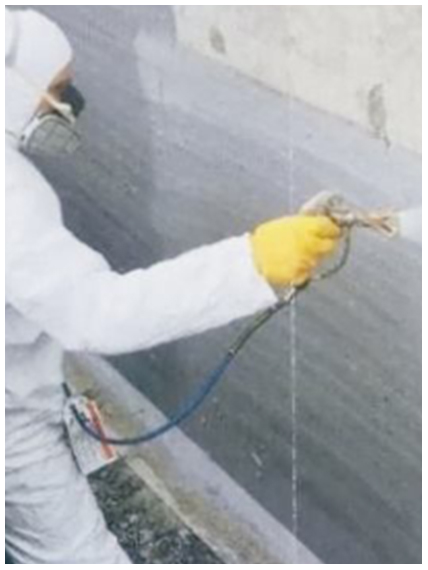

Tehri Dam: Epoxy treatment, intake structures 1 & 2
Planned for 30 days, handed over in 16
Read the phaseBetween windows
No shutdown on record this month. Crews mobilise, plan the next window and keep the year-round work going: Badrinath runs April to December each year, and the mines in Bhutan and Rajasthan keep cutting.
More of the work
Pilgrim buildings, a second granite mine, dam rehabilitation across the Garhwal, and civil and protective work across India.
-

Uttarakhand, 3,583 m

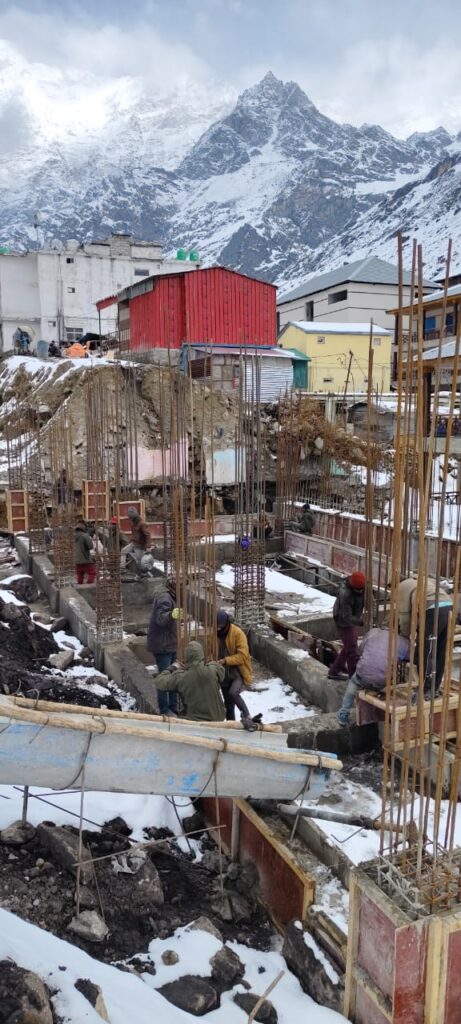

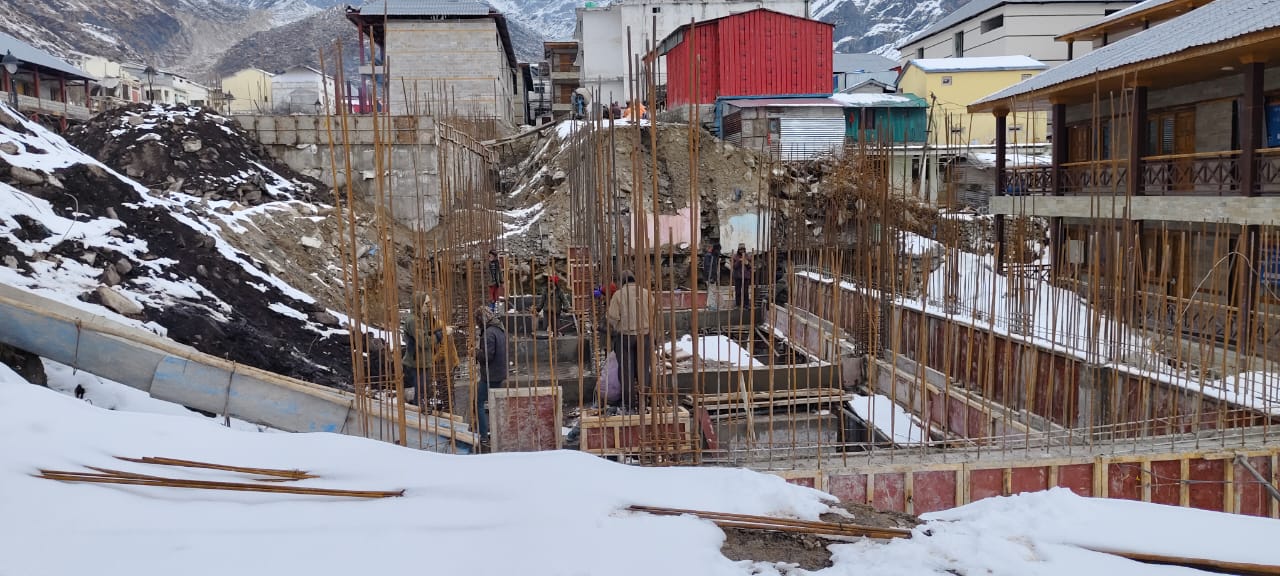

Kedarnath Dham
Pilgrim accommodation blocks Q2Q and Q1N, built between snowfalls.
-

Rajasthan

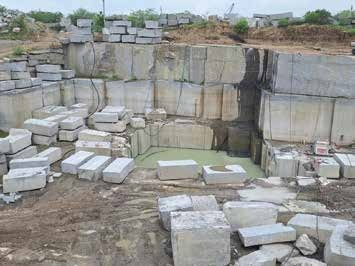

Kekri Granite Mine
Steel Grey, Black Galaxy and Red Galaxy, processed at Rajsamand.
-

Uttarakhand and J&K
Koteshwar, Maneri Bhali, Tapovan
Slope stabilisation, spillway and roller bucket repair, a TBM freed by grouting.
-

Delhi, Punjab, Maharashtra, MP
Civil works across India

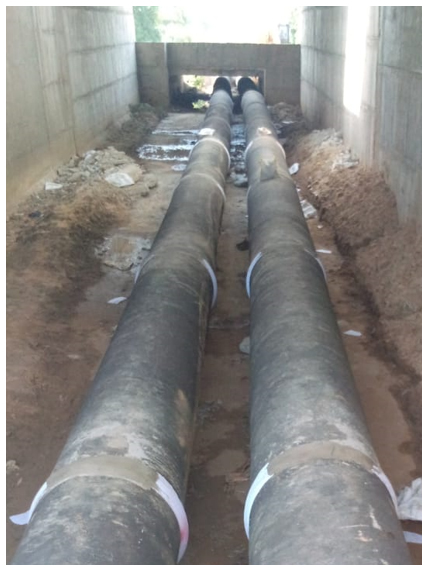

Expressway fire protection, CETPs, 294 km of pipeline coating, refinery insulation.
Growth
143 Cr
Turnover in FY 2024–25, in rupees: almost six times the ₹24.3 Cr of two years earlier.
Pan India and Bhutan
From the shrines of Uttarakhand to granite benches in Wangdue and Kekri, run from a head office in New Delhi. Pick a site to see the work.
Relief and boundaries: Natural Earth
Offices and units
Head office
Pitampura, New Delhi
501, Krishna Apra Business Square, Netaji Subhash Place. Projects are run from here.
OpenBring us the hard one
Tell us the site, the window and the problem. We answer within a working day.
